Risk Strategy

How Much Does ERM Consulting Cost? A Practical Budget Guide

Kennedy Risk Group's published fees, the scope behind them, and a worked budget that includes the costs a consulting proposal can leave out.

By Eric Kennedy · Originally published Thu Jun 18 2026 · Updated Mon Nov 09 2026 · 8 min read

How Much Does ERM Consulting Cost? A Practical Budget Guide

Kennedy Risk Group's published project fees range from $4,500 to $6,500 for an ERM Program Diagnostic to $52,000 to $70,000 for an ERM Foundation Build. A focused risk assessment or reporting engagement sits between those figures.

Those are KRG's prices for defined mid-market engagements, not an industry average. There is no useful single price for work that might mean reviewing an existing program, assessing enterprise risks, or building the process that keeps those risks under review.

For a CFO preparing a budget, the first job is to decide which of those outcomes the company needs. The second is to identify what the quoted fee leaves for your team to do.

KRG's ERM consulting fees and timelines

The following are our published fee ranges in U.S. dollars. The agreed scope determines the fixed fee within an engagement. Revenue alone does not establish fit: the number of entities, stakeholders, locations and reporting requirements also matters.

EngagementPublished feeTimelineMain purpose
ERM Program Diagnostic$4,500 to $6,5001 to 2 weeksReview the current program and identify priorities for improvement
Executive Risk Reporting Suite$18,000 to $25,0003 to 6 weeksBuild reporting, metrics and a review cadence for leadership
Risk Clarity Sprint$22,000 to $27,0004 to 6 weeksAssess and prioritize enterprise risks with consistent ratings and ownership
ERM Foundation Build$52,000 to $70,0008 to 12 weeksEstablish the program's governance, assessment method and operating routines

These offers are designed for mid-market organizations, broadly $50 million to $750 million in revenue. Ongoing advisory is scoped separately. The diagnostic fee is credited toward a subsequent KRG engagement, so a budget that includes both stages should show the credit rather than add the full fees together.

Do not add all four rows to estimate the cost of a program. Their scopes can overlap. Ask which work is needed, which work already exists and how any combined engagement avoids charging for the same activity twice.

A diagnostic and a risk assessment answer different questions

A diagnostic asks, “How well does our risk process work, and what needs to improve?” It reviews governance, methodology, ownership and reporting. KRG's diagnostic includes document review, two to three discovery calls, a maturity scorecard, gap analysis, roadmap and executive memo.

A risk assessment asks, “What could affect our objectives, how exposed are we, and what should we do about it?” That requires input from the people who understand the business, a consistent assessment method and a discussion of the responses management is prepared to make.

Confusing the two creates a budget problem. A small diagnostic may identify that supplier concentration needs deeper analysis. It does not automatically include that analysis, a supplier audit or a replacement-sourcing plan.

If the company already has a credible assessment and clear owners, the missing piece may be better board reporting. If those foundations are absent, polishing the report will leave the harder work unfinished.

What changes the scope and price

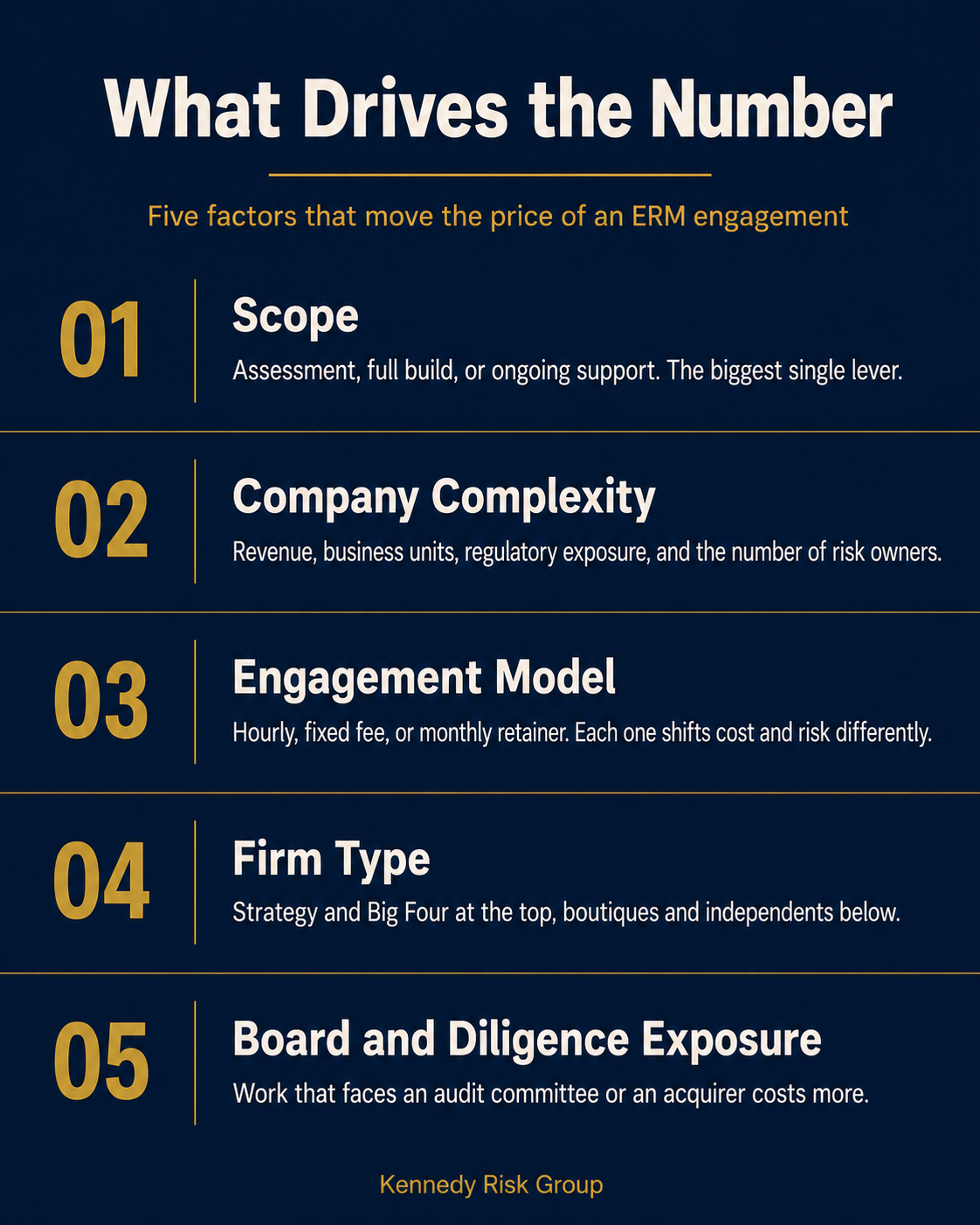

Company revenue is a starting point, but it does not describe the work. Two businesses of similar size can need very different engagements.

The number of different operating realities. Six legal entities using one management team and common processes may require less work than three businesses with separate systems, risk owners and approval routes. Ask which differences need their own assessment and which can be covered together.

The quality of the starting material. An existing register can save time if its definitions, evidence and owners are usable. A long spreadsheet with duplicate risks and untested ratings may need substantial rebuilding. The proposal should state what it assumes about the material you will supply.

The depth of analysis. A leadership assessment, a detailed exposure model and independent testing of controls are different assignments. Specify which risks need further analysis and what evidence the consultant will obtain. Do not assume “assessment” includes testing that the statement of work never names.

The work required to put the process into use. A template is one deliverable. Working through the first reporting cycle, resolving disputed ownership and training the person who will run the next cycle take additional time. Include those activities where they are necessary to make the output usable.

The approval path. A deadline can be expensive when the people who must supply information or approve decisions are unavailable. Ask for a schedule that identifies your team's dependencies, not just the consultant's milestones.

Build a budget beyond the consulting invoice

An outside firm can facilitate interviews, analyze information and develop the reporting. Your operators still need to explain the business, review the findings and decide what to do. That time belongs in the plan even when it does not create a new invoice.

Here is a simple way to separate the cash request from the resource commitment.

ILLUSTRATIVE SCENARIO. A company budgets for a focused enterprise risk assessment and first leadership readout. All figures below are constructed planning assumptions, not KRG quotes, market benchmarks or a client example.

Budget itemCalculationAmount
External assessment engagementAssumed fixed fee$24,000
Specialist review of one exposureSeparate assumed scope$4,000
Data preparation supportSeparate assumed scope$2,000
Planned external cash spend$24,000 + $4,000 + $2,000$30,000
Internal participation50 combined hours at an assumed loaded cost of $120 per hour$6,000
Total planned resource costExternal spend plus internal participation$36,000
Illustrative budget waterfall: a $24,000 assessment fee, $4,000 specialist review and $2,000 data support total $30,000 in external cash. Adding $6,000 of internal time brings total resource cost to $36,000. Internal time is not necessarily additional cash.

If management also holds a $3,000 reserve for an unresolved scope item, the external cash budget becomes $33,000. The reserve is uncommitted capacity, not a fee the consultant is entitled to spend. Approve its use only after agreeing the additional work.

The $6,000 internal allocation is not automatically incremental cash expense. It makes the use of existing capacity visible. Do not count the same employee time again as a separate “opportunity cost” without a distinct, supportable reason.

The example also excludes implementing the eventual risk responses. Replacing a supplier, adding a control or changing a system could require a separate decision and budget. A risk assessment fee should not quietly become the assumed cost of fixing everything it finds.

Put the scope boundaries beside the price

Before signing, ask the firm to complete the following fields in plain language. Use the same fields for each proposal.

FieldWhat the proposal should specify
CoverageEntities, functions, locations and planning horizon included
ParticipationNumber and type of interviews, workshops and review meetings
EvidenceDocuments reviewed, analysis performed and testing included or excluded
OutputsNamed deliverables, editable formats and what makes each acceptable
Internal effortWho must contribute, when and with how much preparation
HandoverTraining, first-cycle support and ownership after the engagement
Separate chargesSoftware, travel, specialist work and applicable taxes, if any
ChangesWho can approve extra work and how it will be priced

A lower fee can be the right choice. A company that needs a narrow assessment should not buy an entire program rebuild. The problem is a comparison in which the missing work becomes visible only after the contract is signed.

For evaluating the team and its proposed outputs, use the ERM consulting buyer's guide.

Fixed fee, hourly or retainer?

A fixed fee works well when the outcome and boundaries can be defined. Check the assumptions and change process. “Fixed” does not mean unlimited interviews, revisions or new workstreams.

An hourly or time-and-materials arrangement can fit an uncertain investigation or a small piece of specialist support. Ask for an estimate, a spending cap or approval threshold, and a point at which the firm must stop and discuss whether to continue.

A retainer can fit recurring facilitation, reporting and advice. Specify the monthly capacity, response expectations, deliverables and what happens during a busy quarter. A monthly price alone tells you little about how much support is available.

If the question is whether to hire rather than retain outside help, compare the full operating models in in-house versus outsourced risk management. A project fee and an annual salary cover different commitments.

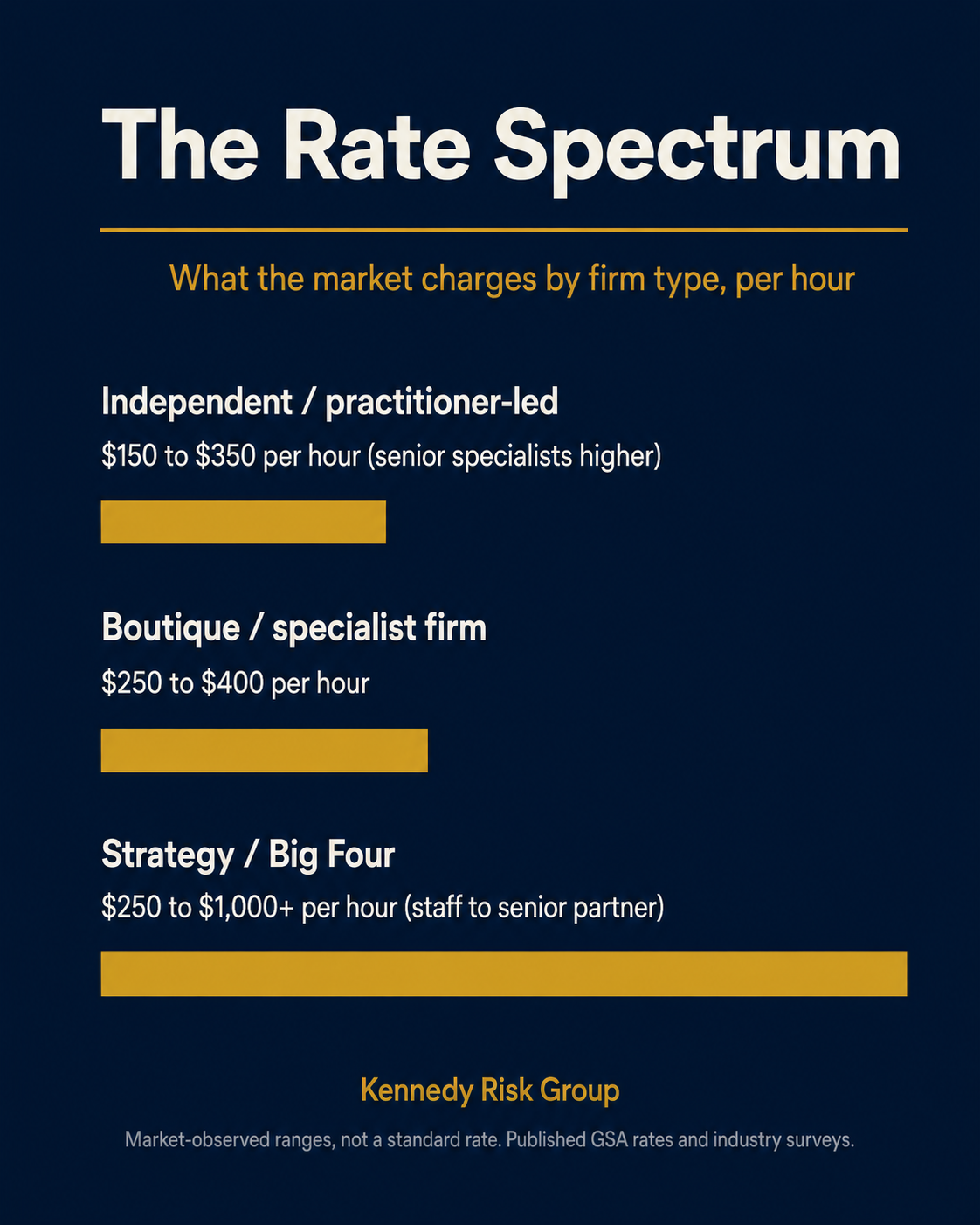

How much weight should you put on public hourly rates?

Public rate data can help you ask questions, but it has limits. The U.S. General Services Administration distinguishes its labor ceiling-rate dataset from its prices-paid tool. A ceiling rate is not evidence that a mid-market buyer paid that amount for an ERM engagement. GSA's pricing documentation

For a meaningful comparison, you would also need the work, staff mix, qualifications, contract terms and actual hours. A striking partner rate does not establish the cost of your project. Nor does a low hourly rate establish a lower total fee.

I would spend more time clarifying those variables than trying to turn a broad consulting-rate range into a budget.

Start with the gap you need to close

Write down what leadership must be able to do at the end of the engagement, what already works and who will run the process afterward. That gives a consulting firm something concrete to price and gives you a basis for declining work you do not need.

If those answers are unclear, KRG's ERM Program Diagnostic is a defined starting point: a review of the current program, its gaps and the next steps worth funding. The fee is credited toward a subsequent engagement if you choose to continue.

Frequently Asked Questions

How much does ERM consulting cost for a mid-market company?

KRG's published fees are $4,500 to $6,500 for a diagnostic, $18,000 to $25,000 for an Executive Risk Reporting Suite, $22,000 to $27,000 for a Risk Clarity Sprint and $52,000 to $70,000 for an ERM Foundation Build. These are KRG fee ranges for defined scopes, not market averages. Confirm internal effort and separate costs before setting the total budget.

Does an ERM consulting fee include software?

Check the scope. Advisory work, software subscriptions, configuration and ongoing administration are different cost items. Do not assume a proposal includes all of them. A spreadsheet or existing reporting tool may be sufficient for the work you need.

What is the difference between an ERM diagnostic and a risk assessment?

A diagnostic evaluates the capability of the risk program and identifies improvements. A risk assessment evaluates the exposures affecting business objectives. The first may recommend the second, but it does not replace it.

Can a fixed-fee ERM engagement become more expensive?

Additional work may require a change to the agreed scope and fee. Set the assumptions, exclusions and approval process before starting. A useful contract makes clear who can authorize a change and requires agreement before the additional work proceeds.
